PMI publishes 170 questions, 240 minutes and a psychometric scoring process, but no PfMP pass-rate percentage. Assess provider claims properly.

By Sanjeev Kumar, Founder · Updated 30 Sept 2026

In brief

PMI currently publishes no official PfMP exam pass-rate percentage or fixed numeric passing mark. It does publish a 170-question, 240-minute format and a psychometric scoring process, so provider rates are provider-specific evidence rather than PMI data.

In this article
  1. 1PMI supplies exam rules, not a population pass rate
  2. 2The official figures that candidates can use
  3. 3A provider rate needs a defined cohort
  4. 4Preparation support should fit the stage you need to clear
  5. 5Frequently asked questions

PMI supplies exam rules, not a population pass rate

As of September 2026, PMI’s current PfMP certification page and PfMP Certification Handbook do not provide an official PfMP exam pass-rate percentage. They also do not provide a fixed numeric passing mark.

That distinction matters. A pass rate is the share of a defined group who passed. A passing standard is the level of performance required of an individual candidate. PMI says its exams are criteria-based and that subject-matter experts use psychometric analysis to determine the standard. A percentage from a forum, a mock exam, or a provider’s own learners is not therefore an official PMI PfMP pass rate.

The practical next step is to separate your exam question from your provider question. Use PMI’s rules to understand the credential, then use a provider’s disclosed cohort and method to decide whether its own outcome figure is meaningful. Start with the PfMP credential and its three eligibility paths before treating any course result as relevant to you.

The official figures that candidates can use

PMI does publish enough information to plan the examination and identify what a preparation claim is not measuring.

Published elementOfficial figure or ruleWhat it tells a candidateSource
Exam format170 questions in 240 minutes, English onlyThe time and question-count benchmark for timed practiceProject Management Institute, current PfMP certification page, 2026
Scored items150 scored questions and 20 unscored pretest questionsNot every question affects the scoreProject Management Institute, PfMP Certification Handbook, 2022
Exam blueprintStrategic Alignment 25%, Governance 20%, Portfolio Performance 25%, Portfolio Risk Management 15%, Communications Management 15%Two domains, Strategic Alignment and Portfolio Performance, account for half of the blueprintProject Management Institute, current PfMP certification page, 2026
Panel gateA candidate must pass panel review before scheduling the examinationExam-only pass claims do not describe every certification stageProject Management Institute, current PfMP certification page, 2026
AttemptsUp to three attempts during a one-year eligibility periodA first attempt is a specific event, not the same as eventual certificationProject Management Institute, PfMP Certification Handbook, 2022
Current PfMP facts published by PMI

A provider rate needs a defined cohort

A useful provider figure begins with a denominator, not a headline percentage. The calculation is verified first-attempt passes divided by defined eligible first-attempt candidates, and each part needs an auditable definition.

Use the six checks in our first-attempt success methodology when comparing a provider’s result. If the figure does not identify who was counted, what event counted as a pass and how unknown outcomes were handled, it cannot answer your likelihood of passing.

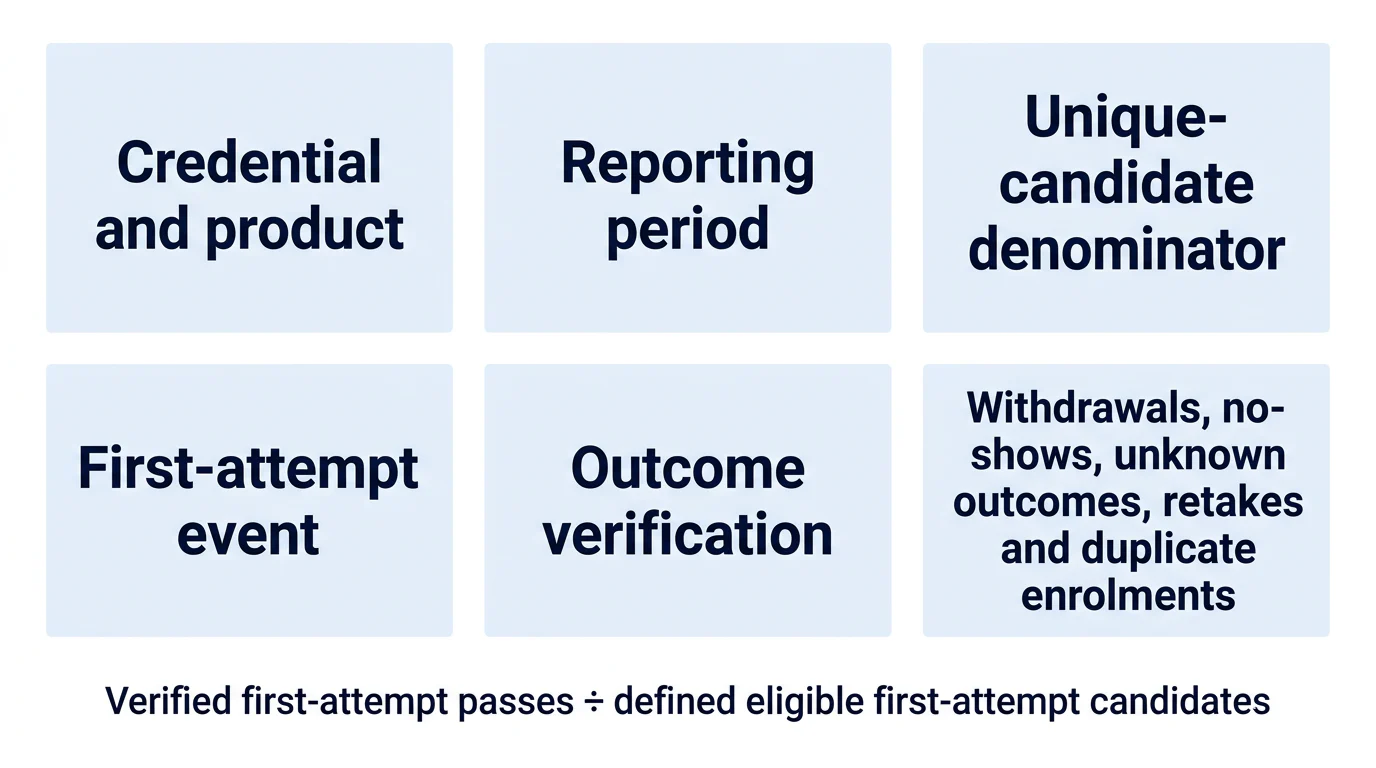

Six disclosures behind a credible provider rateSix checks a training provider should disclose before a reader relies on its first-attempt PfMP pass rate.

Preparation support should fit the stage you need to clear

Our current October 2026 PfMP Fast Track Programme is designed around a 12-week path and costs US$1,100, reduced from US$1,500. We include live online sessions, application support, a 1:1 mentor gap assessment, one-year access to session recordings, self-paced video lectures, 1,000+ exam questions, templates, case studies, community access and a 24-PDU completion certificate.

This programme is for senior managers, programme managers, portfolio managers, PMO managers and professionals moving into portfolio-management roles. It is not a substitute for PMI’s experience requirements, panel review or the candidate’s own exam performance. If your main uncertainty is application evidence rather than exam practice, begin by identifying the support you need through our PfMP certification support guide.

Talk to a certification expert

Share your details and the program you are interested in.

Frequently asked questions

No. PMI’s current PfMP certification page and its 2022 PfMP Certification Handbook explain eligibility, exam format, scoring and retakes, but neither gives an official PfMP pass-rate percentage.
PMI does not publish a fixed PfMP percentage pass mark. Its 2022 handbook says subject-matter experts establish the passing standard through psychometric analysis using scored examination items.
Only when the provider identifies its credential and product scope, period, unique-candidate denominator, first-attempt event, verification method and treatment of exclusions such as retakes and no-shows.
PMI permits up to three attempts within the one-year examination-eligibility period. Re-examination fees apply to the second and third attempts under PMI’s 2022 PfMP handbook.

Keep reading

Augment Consultancy.

Helping professionals worldwide achieve PgMP® and PfMP® certification through expert mentoring, practical learning, and proven success.

© 2026 Augment Consultancy

Powered by PageLens.ai

Talk to a certification expert.
